Project Details

Work Type
Interchange Improvements
Phase
Construction
Project Start
Fall 2023
City
County
Road
Construction Cost
$227.5 million
Estimated Completion
Spring 2027
Contractor
The Lane Construction Corporation

About

The Downtown Tampa Interchange project will improve the safety and operations of the I-275/I-4 interchange in Tampa. Improvements include:
Southbound I-275 to Eastbound I-4

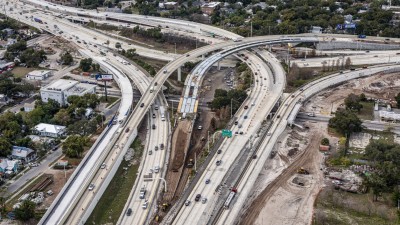

  • Providing a two-lane exit and constructing a new exit ramp bridge (to the inside of the interchange) from SB I-275 to EB I-4

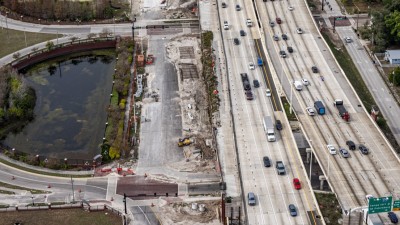

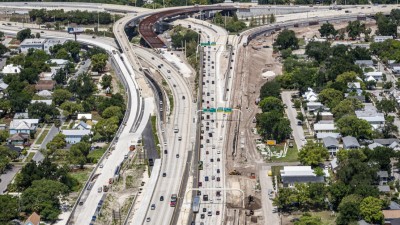

  • Changing the EB exit ramp from I-4 to Ybor City by relocating access to14th/15th Streets instead of 21st/ 22nd Streets
  • Widening the existing EB I-4 frontage road (13th Avenue) to two lanes

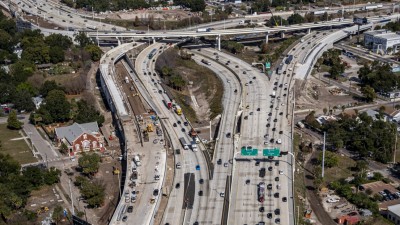

Westbound I-4 to Northbound I-275

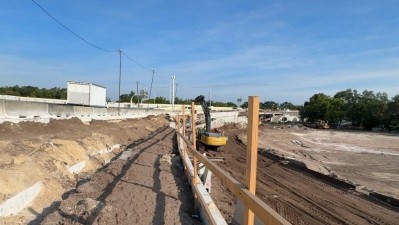

  • Widening the existing single lane ramp from WB I-4 to NB I-275 to two lanes
  • Adding an additional merge lane on NB I-275 between I-4 and the Dr. Martin Luther King Jr. exit to the west of the current alignment

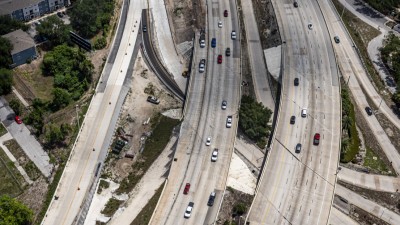

Westbound I-4 to Southbound I-275

  • Widening the existing two-lane ramp from WB I-4 to SB I-275 to three lanes
  • Widening the shoulders on SB I-275 between Palm Avenue and Jefferson Street

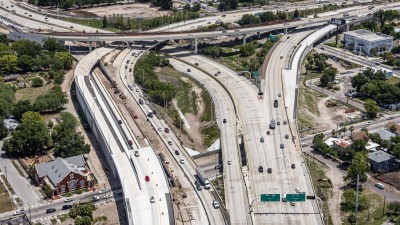

  • Shifting the exit ramp from SB I-275 into downtown Tampa to the west of the current alignment

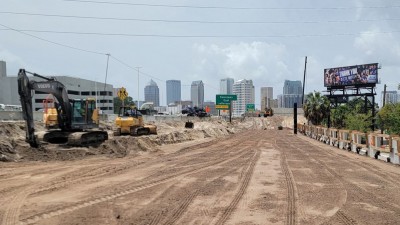

      To construct the project, heavy machinery will be used during daytime and nighttime hours and at times, may produce noise, vibration, and require the use of bright lights during nighttime work.

      Work requiring lane closures will occur at night between 9 p.m. and 6:30 a.m. Occasionally, interstate ramps may close at night between 11 p.m. and 5 a.m.

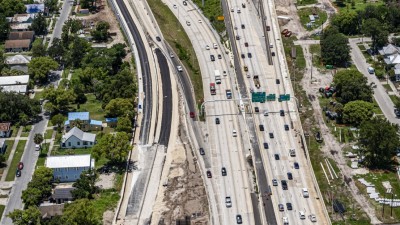

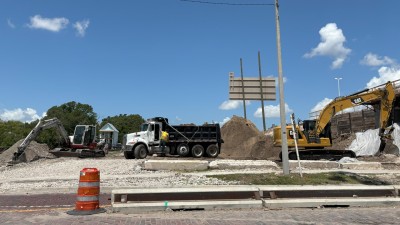

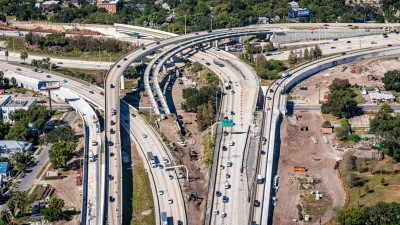

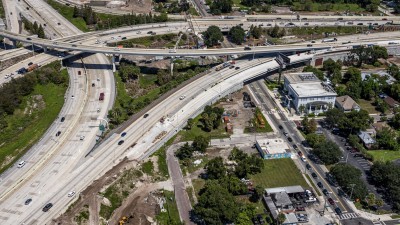

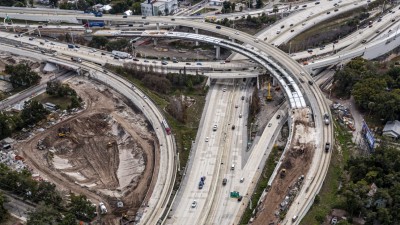

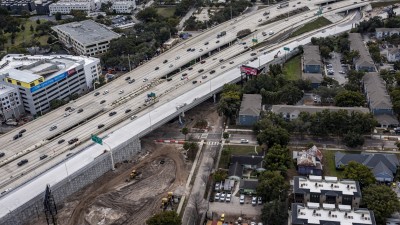

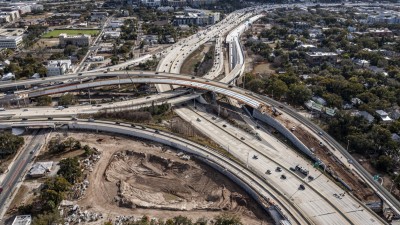

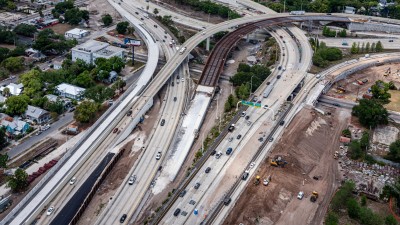

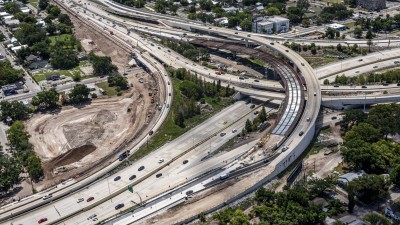

      Current Work Activities (August 2026)

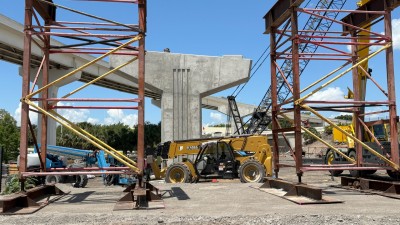

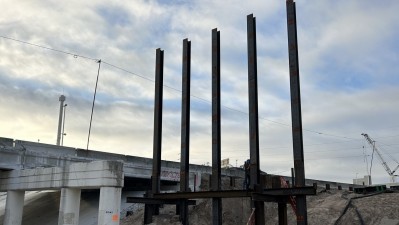

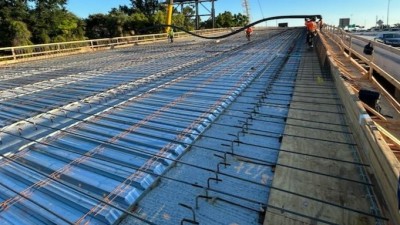

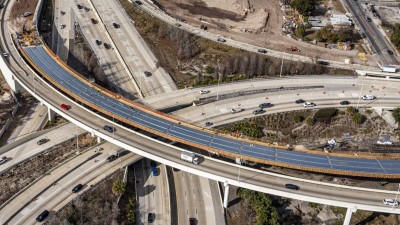

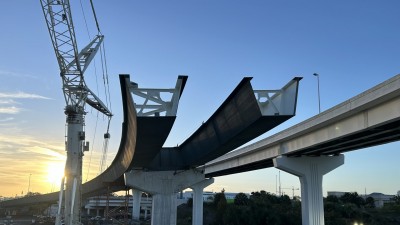

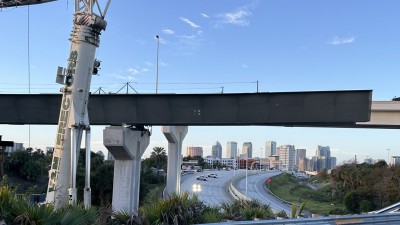

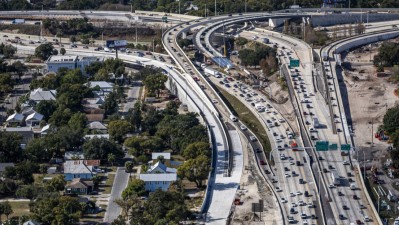

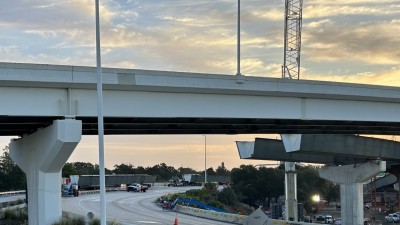

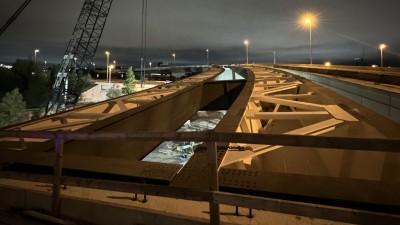

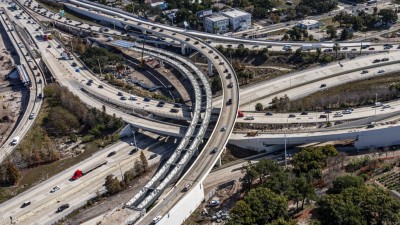

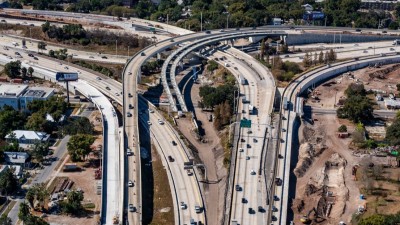

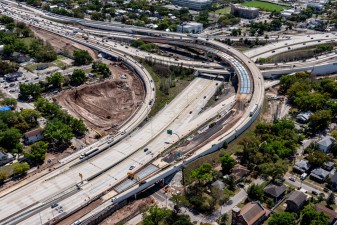

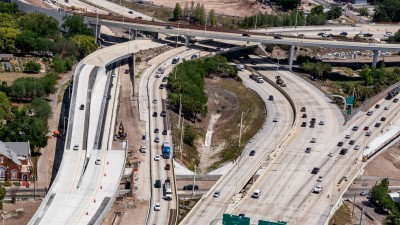

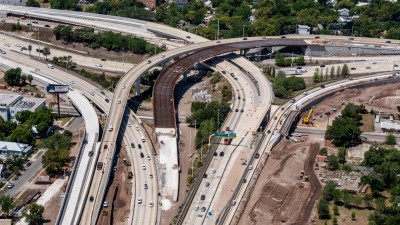

      • 100% of steel girders installed over Nebraska Avenue for the new ramp from SB I-275 to EB I-4
      • 100% of concrete pavement installed for new exit ramp from NB I-275 to Ybor City

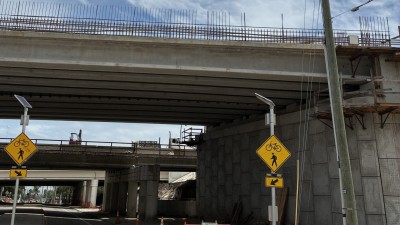

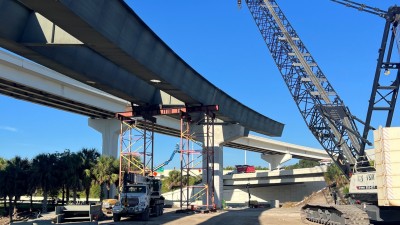

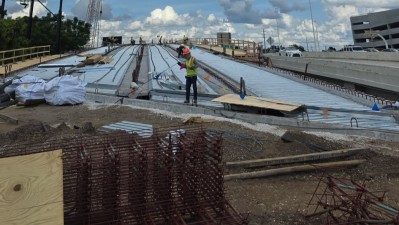

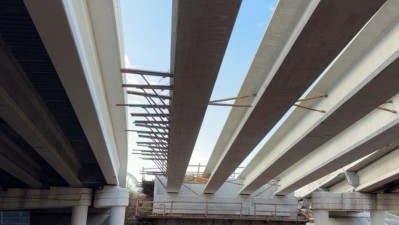

      • 100% of bridge decks installed for the new ramp over Palm Avenue

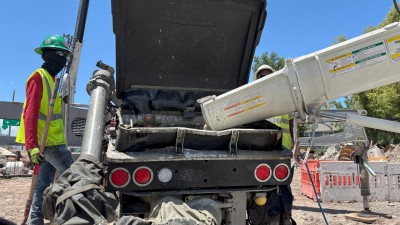

      • 96% of utilities relocated

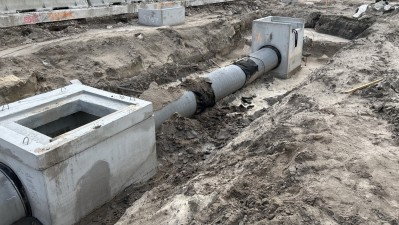

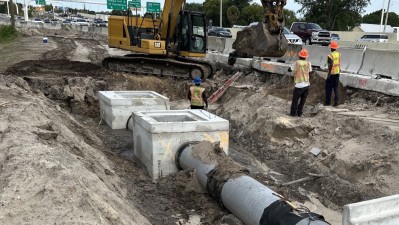

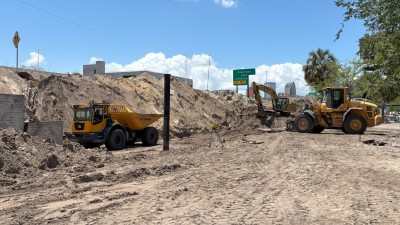

      • 91% of old storm drainage pipes removed
      • 89% of new major drainage pipes installed

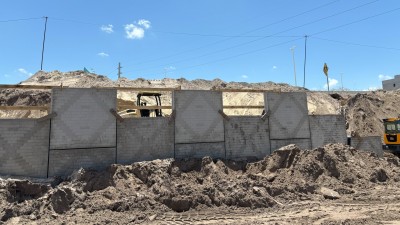

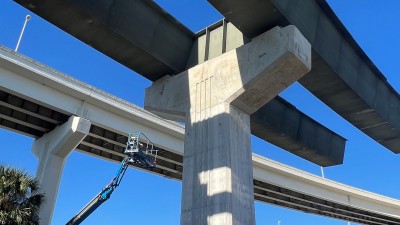

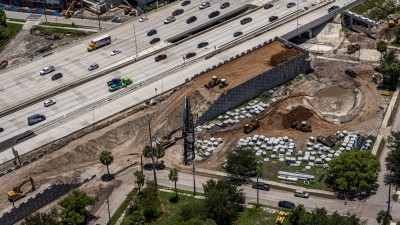

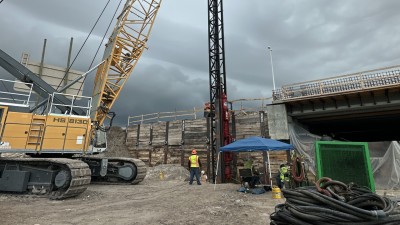

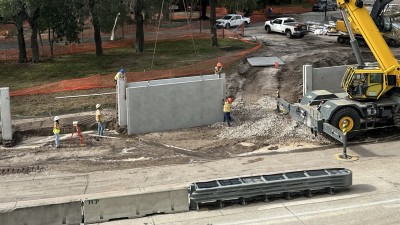

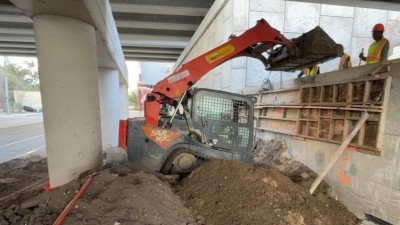

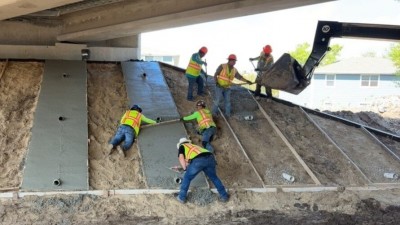

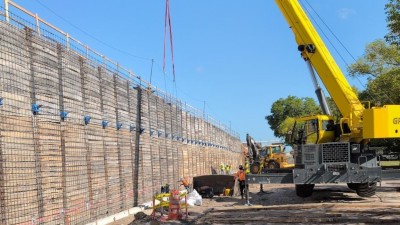

      • 85% of Mechanically Stabilized Earth (MSE) walls installed

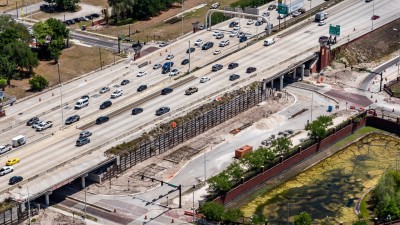

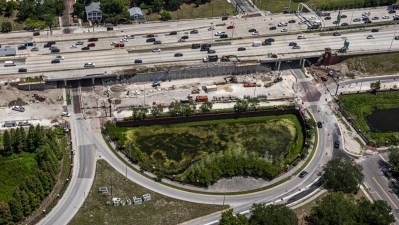

      • 85% of new Intelligent Transportation Systems (ITS) fiber installed, lighting and signalization at 14th and 15th streets is ongoing

      This project is expected to finish spring 2027.

      To receive construction updates and traffic alerts via email, be sure to subscribe above.

      FDOT project numbers 445057-1, 445056-1 and 445056-2 have been combined into a single construction contract. All updates and alerts will be posted on this page.

      *Construction cost includes original construction contract amount plus approved contract changes. It does not include inspection oversite.
